Port Stanley Storm Sewer Upsizing – Phase 1A

Share Port Stanley Storm Sewer Upsizing – Phase 1A on Facebook Share Port Stanley Storm Sewer Upsizing – Phase 1A on Twitter Share Port Stanley Storm Sewer Upsizing – Phase 1A on Linkedin Email Port Stanley Storm Sewer Upsizing – Phase 1A link

The Municipality of Central Elgin will begin the first phase of the Port Stanley Storm Sewer Upsizing project in 2026. This project will address storm water capacity in Port Stanley that can contribute to localized flooding, pooling water on roads, and strain on existing infrastructure.

Phase 1 includes installing larger storm sewers and improving drainage outlets so the system can better handle heavy rainfall, including the impacts of climate change. These upgrades will help reduce the risk of road flooding and service disruptions, and improve safety and reliability during significant rainfall events.

PROJECT SCOPE

Phase 1 of the Port Stanley storm sewer upsizing project consists of storm sewer and outlet upsizing along William Street, Edith Cavell Blvd, Maud Street, Bessie Street, and Lotus Lane. A new storm sewer will be added to Maud Street and Bessie Street where one does not currently exist.

Maud Street and Bessie Street road surface will also be rebuilt to a proper road structure with new curb and gutter. Watermain works will consist of replacing the existing watermain with new PVC watermain on William Street between Erie Street and Edith Cavell Blvd as well as replacing all water services on William Street (between Erie Street and Edith Cavell Blvd), Bessie Street, and Maud Street.

PROJECT SCHEDULE

The construction schedule for the storm sewer replacement project has been strategically developed to avoid the tourist high season for safety, construction efficiency, and with consideration to local businesses.

There will be no construction between the May long weekend and September long weekend. To accommodate this restriction, the Port Stanley Storm Sewer Upsizing – Phase 1 project is separated in two parts.

  • Part 1A will consist of Spring work (March 2026 to May long weekend) along William Street, Edith Cavell Blvd, and the Hofhuis park outlet.
  • Part 1B will consist of Fall 2026 to Spring 2027 work along Maud Street, Bessie Street, and Lotus Lane.

Additional to Part 1B (Maud Street and Bessie Street), Enbridge Gas will be renewing their gas main and services to each property on Maud Street and Bessie Street, and ERTH Power will be adjusting power poles on Maud Street.

PROJECT AREA


Part 1A: Work to be completed by May 15, 2026.

Part 1B: Project to be tendered later in the year. Work to be completed between September 2026 and May 2027.



The Municipality of Central Elgin will begin the first phase of the Port Stanley Storm Sewer Upsizing project in 2026. This project will address storm water capacity in Port Stanley that can contribute to localized flooding, pooling water on roads, and strain on existing infrastructure.

Phase 1 includes installing larger storm sewers and improving drainage outlets so the system can better handle heavy rainfall, including the impacts of climate change. These upgrades will help reduce the risk of road flooding and service disruptions, and improve safety and reliability during significant rainfall events.

PROJECT SCOPE

Phase 1 of the Port Stanley storm sewer upsizing project consists of storm sewer and outlet upsizing along William Street, Edith Cavell Blvd, Maud Street, Bessie Street, and Lotus Lane. A new storm sewer will be added to Maud Street and Bessie Street where one does not currently exist.

Maud Street and Bessie Street road surface will also be rebuilt to a proper road structure with new curb and gutter. Watermain works will consist of replacing the existing watermain with new PVC watermain on William Street between Erie Street and Edith Cavell Blvd as well as replacing all water services on William Street (between Erie Street and Edith Cavell Blvd), Bessie Street, and Maud Street.

PROJECT SCHEDULE

The construction schedule for the storm sewer replacement project has been strategically developed to avoid the tourist high season for safety, construction efficiency, and with consideration to local businesses.

There will be no construction between the May long weekend and September long weekend. To accommodate this restriction, the Port Stanley Storm Sewer Upsizing – Phase 1 project is separated in two parts.

  • Part 1A will consist of Spring work (March 2026 to May long weekend) along William Street, Edith Cavell Blvd, and the Hofhuis park outlet.
  • Part 1B will consist of Fall 2026 to Spring 2027 work along Maud Street, Bessie Street, and Lotus Lane.

Additional to Part 1B (Maud Street and Bessie Street), Enbridge Gas will be renewing their gas main and services to each property on Maud Street and Bessie Street, and ERTH Power will be adjusting power poles on Maud Street.

PROJECT AREA


Part 1A: Work to be completed by May 15, 2026.

Part 1B: Project to be tendered later in the year. Work to be completed between September 2026 and May 2027.



  • Construction Update Week of March 2

    Share Construction Update Week of March 2 on Facebook Share Construction Update Week of March 2 on Twitter Share Construction Update Week of March 2 on Linkedin Email Construction Update Week of March 2 link
    supporting image

    Construction has started for the Port Stanley Storm Sewer Upsizing – Phase 1A project. Construction equipment is staged at the Lotus Lane Parking Lot and work to dig out the berm has begun.

    Phase 1A will take place until the May long weekend and will include work along William St., Edith Cavell Blvd., and the Hofhuis Park outlet.



  • Notice of Construction

    Share Notice of Construction on Facebook Share Notice of Construction on Twitter Share Notice of Construction on Linkedin Email Notice of Construction link
    supporting image

    Residents and business owners in the project area received a construction notice with project details and information regarding impacts during construction.

    View the Construction Notice.

    The project is scheduled to start on March 2nd, 2026 and anticipated completion is May 15th, 2026.

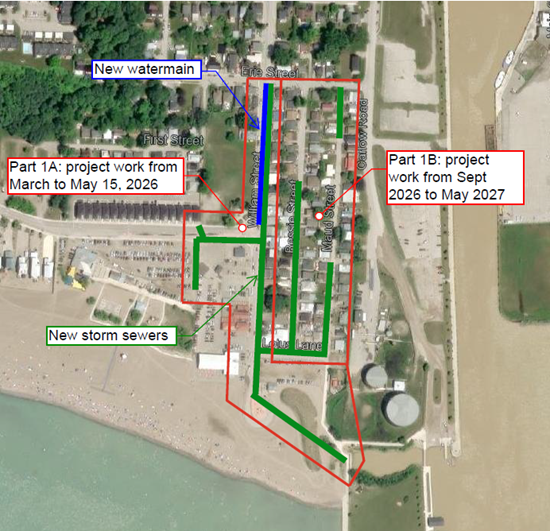

    Map of Phase 1AMap of Phase 1A

  • Tender Awarded: Cassidy Construction London Ltd.

    Share Tender Awarded: Cassidy Construction London Ltd. on Facebook Share Tender Awarded: Cassidy Construction London Ltd. on Twitter Share Tender Awarded: Cassidy Construction London Ltd. on Linkedin Email Tender Awarded: Cassidy Construction London Ltd. link
    supporting image

    At its Meeting on Monday, February 9, Central Elgin Council awarded the tender to Cassidy Construction London Ltd. to complete the Port Stanley Storm Sewer Upsizing- Phase 1A project.

    View the Council Report.

Page last updated: 06 Mar 2026, 02:38 PM
